Revision as of 17:31, 23 August 2023

Items Needed for Setup

  • New IDGSDVR unit w/ accessory kit
  • New SSD
  • Power Supply
  • Power & Ground banana plugs to 8 pin power cable
  • A input/output medium, i.e.
    • Remote control + 6 pin to RCA cable with RCA to USB adapter for viewing on Amcap software (yellow is video)
    • Remote control + 6pin to 4 pin adapter cable + monitor
    • Stonkam 6 pin Touch Screen monitor
  • SIM Card

NOTE: the 6 pin video out is labeled "AV OUT"

Login

Admin Account

User Names are case sensitive

Default user name admin

Default password 123

After Config:

user name ADMIN

password IDGD8

Guest Account

The Guest account limits Menu Access to Playback and Volume only

Default "Guest User name : guest

Default Guest Password: 321

Change Guest to: BNSF

Password: 249805 (SB street address and area code)

Routine Setup

Follow along with a IDGSDVR Configuration Checklist.

Document Device ID / Serial Number

Each Stonkam DV454 & 456 has a 9 digit unique Device ID (Serial Number) Located in System>Info

Write this down on the traveler.

  • Device ID (AC uses this as the DVR Serial Number)
  • Printed on the Label which goes on the DVR

Example: Device ID 307260025 will be Serial Number 307260025

Install Batteries in Remote Control

From the accessory kit. We will not be sending a remote control for each DVR. We will ship some quantity to a location and only these need to have batteries installed.

Install and Format Hard Drive

Click on the Floppy Disk Icon on main menu

Hard Disk Installation Detail

Format Hard Disk Detail

Wait for a format successful message. (this should take approximately x minutes for a 1TB hard drive)

Upgrade Firmware and Verify

Get current version from AC

Upgrade Firmware

Verify Version

Install Config File for vehicle type (Handler or Crane)

Config Detail

Download contains 8 configuration files. 4 for Cranes files, 4 for Loader files, 4 of each type for US time zones(EST, CST, MST, PST)

[|Stonkam BNSF D8 Config Files 050519]

Install SIM Card Installation

SIM Card Installation

Document the number on the Traveler

Keep the plastic card and note the vehicle number on it.

Set device/vehicle specific settings (tag device with vehicle number) (document on traveler)

License No. (vehicle name)
Device No. (EX: 307260025)
Time Zone – verify time correct for that zone
Anything else specific to this one device?

Save Configuration to hard drive and keep a copy in the support folder

SSD

Export the configuration to the SSD

Thumb drive

Export the configuration to a Thumb drive.

Copy the config file to our system (Idrive Support> BNSF> Config_files> Location Name> vehicle_number_sv_xml.xml)

This way we have a record in case we need it.

Labels

Stkm dvr lable.jpg

Print 3 IDGSDVR S/N Labels (one for IDGSDVR, one for the DVR box and one for outside of the shipping box)

Label on Front of IDGSDVR as shown (So Installer and Customer can identify the device for support)
Vehicle Name
DVR UID – (UID ALL 9 digits)
SIM S/N
Label Download (template requires Zebra Designer software to open)

Remove Extra Items from DVR Kit

Remote Control (this will be shipped in the Location Items box)

Keys (ship one with the individual DVR and save the second at Idrive)

Monitor Cable (6pin - 4 pin)(this will be shipped in the Location Items box?)

CAN Cable

Alarm Cable

Serial Cable

Network Cable

Pack DVR For shipping

  • Camera and Cable Kits will be packed in separate box. (Only the IDGSDVR is vehicle specific however the Crane package will be different and marked accordingly)

TBD ( If Ordered) *Each location will receive a Monitor, Monitor Cable, Extra Hard Drive, Hard drive reader(back ordered), A few remote controls and sets of keys.

Enter IDGSDVR into Admin Center

In the Manufacturing section select the "D4-DVR Production" Tab

click Add (Upper right in small font)
Enter serial number (This is the Full "UID" and not the "Device Id")
Click Add Device
Assign Device to the Customer and Location

For BSNF adjust the Warranty to three years (add two years to the default warranty date)

Assign DVR to a Vehicle in Control Center

Add Iris method

  • Log into the "BNSF CC" (in RMA area)
  • Go to Fleet Manager => Personnel => Add new person and fill in the appropriate info
  • Go to Vehicles => Add new vehicle => Fill in the appropriate info
  • Go to Devices/Drivers section => D4 Device => and click on the "..." button
Select the serial number
Click Assign
  • Click Save Vehicle

LTI Tracking / Global Center -- Redo

Notes:

A vehicle will not show up in the LTI interface until after the first connection

You can see is a device in AdminCenter:

Support>Customer>Location>D4
Click on the device serial number
Select the "Health" Tab

Go to GPS Tracker => Operations => Manage Alerts

Lti manage alerts.jpg

Add Alert

Lti add alerts.jpg

Click Add Alert

Lti add alert controls.jpg

Alert Controls will expand

Alert Types

Lti alert type.jpg

Select the alert type you want ( Camera Disconnected for BNSF)

Name the new Alert (Location Camera Disconnect)

Assign the Alert

Select the vehicle you want to assign the Alert(s) to.

Notifications

Lti sel email notification.jpg

Click on Notifications tab "Envelop" button

Select an email you want to send this alert notification to

  • Terminal Manager or appointed location manager (Should be in the pull-down menu if entered in CC)
  • bnsfalerts@idriveglobal.com (distribution list for Idrive)

click on Save Alert and you are done!

Alert Filters

Our server filters out spurious alerts to limit false notifications:

RO set up these filters and never communicated the final version(s) of what is going on

This alert is from a crane that has the splitters attached to it and they lose power when the power to the crane monitor system is shut off but the cameras connected directly to the DVR remain on. rule that filters out alerts that have camera 1,2,3,4 functioning with video but 5,6,7,8 with video loss. Since the DVR remains on it will continue to check in at the programmed interval so comparing the video loss to the last check in time will not filter them out.

"the second filter which filters the alarms coming at the same time for more than 2 cameras"

"Few days ago, he also applied the one that filters “not recording” alarms"

"We are creating now an algorithm to filter these camera disconnects (in the end probably we need a machine learning one … ), if more than 2 cameras are received in a row having the same time(+/- few seconds) – is hard to believe that 3 cameras can fail or someone can disconnect all 3 at the same time(this should cover all installation alternative). We will discard all “not recording” alerts in case the “currant” status (at connection) reports recording. Also all alerts older than the previous connection time will be discarded"

Assign (name) SIM In Podsystems (Chrysta activates)

Assign and Activate SIMs at ship time. Give the list to Chrysta. Include SIM Serial number , BNSF Vehicle number, BNSF Location

Document the Customer, Location, Vehicle Name, SIM number and give to Chrysta

https://www.freedom2manage.com/user/login

Username:

Password:

Enter the SIM Card Number int the "Quick Filter" box

Click on the SIM Number to open the information page

Enter

  • Name (customer / Location Vehicle) Example: BNSF SIG T0314
  • Status - Change to active
  • Bundle - Select the Bundle UKJ 10MB @ 0.70 OU 0.55USD Idrive Z0
  • For BNSF D8 Alerts use: xxxxxxxx
  • For Intermodal X2s use: xxxxxxxx
  • ETC
  • Date - Select date (what is this for?)
  • Data Credit Limit (what are the amounts for the different types of clients)
  • Alerts (what do we want here?)
  • Alternate Email Alerts (create role account for distibution? Remove sean@idrive... as main email?)

Kit the other items for the vehicle (Cameras, Cables)

Main Menu

The Main Menu is Displayed by pressing Menu on the remote. If using a touch screen touch the bottom half of the screen. Entering any of these menus will stop the device from recording.

Stkm main menu.jpg
1)**Manually Control - Record, Play, Stop, FF, RW
2)**Playback - Search by date & Time
3)**Logs - System & Export Logs
4)*Display Mode - Switch Grid view from Channels 1-4, 5-8 or 1-8
5)**Configuration Settings - Record,Display, Network & System settings
6)**Storage - Manage SSD, SD, USB
7)**Volume - Playback Volume

Manually Control

Playback

Stkm search videos.jpg

A date marked in green indicates that there were videos recorded that day.

Click the day to view the list of enter the video files for that date

Choose the desired video and press the Play button.

You can play single or multiple videos
Multiple videos can be played in sequence and can shift into the next or the previous one.

Select and Play Videos

Stkm search videos2.jpg
Normal
Event
Capture
Play
All
Exit

AL, I think "Capture" can be used to save the video to USB Stick. Might become more practical than swapping the hard drives. I have not tested this.

Logs

Stkm logs.jpg

Used to keep a log of events in the system

Navigate to Menu->Setup->Log

System Log

Stkm system log check.jpg

Feature allows you to search the Systems Log of events on the machine

This log can be found on the hard drive in the "Log" folder

Video Loss now is shown in Syslog

Disconnect camera #1 "Camera State Change:227"
Reconnect camera #5 "Camera State Change:224"
Disconnect camera #5 "Camera State Change:240"
Reconnect camera #5 "Camera State Change:224"

Also no "Fault" light

Export Log

Stkm export log 2.jpg

Use this feature to export the system log.
Log can be exported to SSD, SD, USB

Configuration Settings

Record

Stkm record settings.jpg

Picture is incorrect listed settings are correct

  • Power On Rec ON
  • Cyclic Rec. - Overwrite? ON
  • Event Rec. OFF
  • Event Duration - 15 Seconds
  • File Length - 15 Minutes
  • Motion Sensitivity - OFF
  • G-Force Sensitivity - OFF
  • File Type - AVI

Video Quality

Main Stream
Stkm video quality main.jpg

Resolution: D1(NTSC)

Bit Rate: 2Mbps

Frame Rate: 20fps

Sub Stream

Resolution: CIF(NTSC)

Bit Rate: 64Kbps

Frame Rate: 20fps

JPG

Frame Rate: LOW

Record Channel

Stkm Record Channel.jpg

Green means channel is enabled to record.

Loaders use channels 1,2,3,4

Cranes (mostly) use channels 1,2,3,4,5,6,7,8

Display

Stkm display settings.jpg

*Camera - Brightness, Contrast Etc for each Camera

*Cam Name - Name of Channel on Display

*Language - Set system Language

*Audio Out - Select Channel Audio to listen to

*Camera - Brightness, Contrast Etc for each Camera

*OSD - On Screen Display Information

*Menu On - How lon Menu is Displayed before logout

*Speed - Speed Settings

*GPS - GPS Location Information

*Mirror - Mirror the Camera Image

*Sys Format - NTSC, PAL, Auto

Camera

Stkm Cam name 1.jpg

Individual Camera settings:

  • Brightness
  • Contrast
  • Saturation
  • Hue

Cam Name

Stkm Cam name 3.jpg

Each camera has its own channel with its own "channel name".

Navigate to the display tab by hitting Menu->Setup->Display

Choose which camera name you would like to change by selecting its associated channel name. (8 letters max)

Loader Cam Names
  • CH1 - CAB
  • CH2 - L-Front
  • CH3 - R-Front
  • CH4 - Rear

Crane Cam Names
  • CH1 - CAB
  • CH2 - L-Front
  • CH3 - R-Front
  • CH4 - Far-Side
  • CH5 - CH8 - these channels need to be mirrored for cranes

Language

Stkm Language selection.jpg

To edit the language of the device access Menu->Setup->Display->Language

Select which language you want from the buttons presented. Languages available are English, French, German, Russian, Japanese, Italian, Austrian

Audio Out (N/A for BNSF)

Stkm Audio out.jpg

This setting edits the output for the audio channel in split mode

Navigate to this setting by selecting Menu->Setup->Display->Audio Out

Select which camera's audio you would like to output.

OSD

Stkm OSD settings.jpg

OSD controls what information gets overlayed on the video of each camera.

Navigate to this setting by selecting Menu->Setup->Display->OSD

  • Time - ON
  • License - ON
  • Camera Names - ON

Menu On

Stkm Menu on settings.jpg

Sets the duration of time the menu will display on the screen.

Navigate to this setting by selecting Menu->Setup->Display->Menu On

Settings: 30, 60, 120 seconds, or always on. ::*Time - Always On

Stkm Menu lock setting.jpg

The menu lock setting will lock the menu to be password protected.

A password is needed to change this setting

  • Menu Lock - ON

Speed

Stkm speed setting.jpg

Allows you to change the source of the displayed speed to either the GPS or the vehicle speedometer as well as the units of speed to be either kph or mph

Navigate to this setting by selecting Menu->Setup->Display->Speed

GPS

Stkm GPS settings.jpg

Displays information of latitude/longitude, detectable satellites, connected satellites, speed, and time

Navigate to this setting by selecting Menu->Setup->Display->GPS

Mirror

Stkm Mirror Cam.jpg

Mirrors the video output on the selected camera. Configurable to each camera

Navigate to this setting by selecting Menu->Setup->Display->Mirror

SYS FORMAT

Set NTSC/PAL/AUTO

Network

Stkm network settings.jpg

*Lan - Lan Settings

*Wifi - Wifi Settings

*Cellular - Cellular Settings

*Status - Networks Status

*Server - Server Settings

*FTP - FTP Settings

LAN

Stkm network lan.jpg

Defaults:

IP Address 192.168.100.188 set to 192.168.0.250
Mask 255.255.255.0
Gateway 192.168.100.1 set to 192.168.0.1
MAC Add: 7e:97:15:xx:xx:xx

Notes:

I can ping it but not login. There does not appear to be any access from the network only connectivity with a local server

WiFi

Stkm network wifi.jpg

N/A - Optional

Wi-Fi ON/OFF

DHCP On/Off

Ap Internet (new setting) Off

need new picture

Cellular

Stkm network cellular.jpg
  • Cellular - ON
  • Standard - WCDMA
  • APN - data641003
  • Access No. - *99#
  • User Name - BLANK Can only be set by Config file
  • Password - Blank Can only be set by Config file

Status

Stkm network status.jpg

Displays information on:

Lan IP address
MAC Address
3G/4G Network Status
3G/4G Signal Strength
Wifi Network Status
Wifi IP Address
Wifi Signal Strength
Server Status
Network Connectivity

Server

Stkm network server2.jpg

Server Address: lti-api.idriveglobal.com Port 8898

DVRs shipped prior to 1/29/18 did not support DNS for Server identification. The following IP address was used:

Server IP 34.194.3.17 port 8898

FTP

Stkm network ftp.jpg

System

Stkm system settings.jpg

*User - User Password

*Device - Vehicle, Device, Path information

*Date & Time -

*Schedule - Timed Recording

*Exception - Buzzer On/Off and duration

*Acc -

*Alarm -

*Update -

*Config -

*Info -

User

Stkm system usr.jpg

Device

Stkm system device.jpg

License No. - Default:(AAAAAA) Set to Vehicle Name

Device ID - Default:(BBBBBB) Set to UID(last 8 Digits only) Example: 07270002

Path No. - Default (CCCCCC) Not Used (removed in later FW releases)

From Stonkam 8/11/17 "it is a feature reserved for adding bus number in the future if the customer needs"

Date & Time

Out of Date - missing Time Sync, Daylight Savings

Stkm system datetime.jpg

Set for customer location

Stkm system timeformat.jpg

Timezone: Set to PST is -8

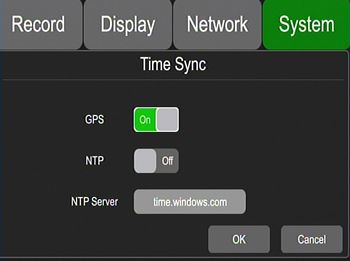

Stkm system timeupdate.jpg

Time Sync: Set to GPS on NTP off

Stkm system daylight savings.jpg

Enable: Set to ON

Start time / End time: Set to As Shown

Schedule

Stkm system schedule.jpg

Used to schedule up to 4 recording tasks.

Recording settings include a start & end time as well as day of the week to record.

Note: Recordings are permitted to overlap

Exception

Stkm system exception.jpg

Settings to configure a buzzer when certain errors occur.

Example: Buzzer when camera becomes disconnected

ACC

Stkm system acc.jpg

Displays:

Current voltage of the DVR
Shutdown voltage- If voltage < shutdown voltage then dvr shuts down, powers back on only when voltage exceeds shutdown voltage
ACC Delay- Continued recording after ACC is disconnected. Options are 5,30,60 seconds

FW 20180117 changes ACC Delay values to 5s, 60s, 30min, 60min

Alarm

Stkm system alarm.jpg

Need picture update

Alarm Out - all to off

Alarm Rec. - Off

Update

Stkm FW Upgrade.jpg

Process takes ~ 3 Minutes

Ensure you are using the latest FW version (Downloads section of A/C)

Eric's note: USB would not mount unless first formatted in the D8. Windows will see the D8 formatting as something it needs to "scan and fix". Do not "fix" this.

Copy the firmware to USB stick or SD card root directory.

Insert the USB Stick into the DVR.

Either:

  • Reboot the DVR or
  • Navigate to Menu -> Setup -> System -> Update> Hit OK

Wait for Update Success!

Verify that the update was successful by Menu -> Setup -> System -> Info

Compare the current version to the desired version.

Upgrade Notes

New FW dv424_upgrade_201801171957 received 1/16/18. Mark's notes:

Upgrading no longer deletes the configuration files. However you must remove the thumb drive after the update and before it reboots or else it will update again and again and...

Upgrading requires reformat of Hard drive and all data will be lost!!!

Updates after 20181017 will not format the HDD/SSD since the filesystem changes have already been made

Currently, the upgrade package is deleted from the USB stick after the upgrade process is finished. To prevent having to recopy the firmware to the USB stick rename the file.

Example of Firmware Name: “dv424_upgrade_201801171957”

Change Name to : “dv424_upgrade_never_rename”

Step 2:Copy the package to USB disk or SD card root directory, and insert it to DVR.

Step 3:Power off the DVR and reboot it, then it will auto upgrade. Or in the menu Menu -> System -> Update, click OK to confirm to upgrade. Both method can start the upgrade process.

Stonkam Notes:

The flash size of our DVR is 58M. it is normal for the upgrading package when is less than 58M. The actual size of the upgrading package depends on how much it will be upgraded.

The DVR will start upgrading only after the success calibration of the package files. if the calibration fail, DVR can not upgrade.

There is a debug interface on DVR, so even something wrong with firmware, can recover DVR through the debug interface, so it will not be a brick.

Config

Missing Auto Reboot setup

Stkm Config update.jpg

Note: When you select Import or Export it executes with "OK" you think it is hung but is working

Import

Insert the USB with the appropriate configuration file sv_xml.xml in its root directory

Eric's note: filename must match exactly, you might have to rename if downloaded from the AC

Select the import button

Export

Select Export, Select location (SSD or USB or SD)

Saves sv_xml.xml to location

Factory Reset

Auto Reboot

On/Off, Day of Week, Time of Day

Set to On, Sunday, 02:00AM

Storage

Stkm main storage.jpg

Filesystem Structure

Log4Gui - ASCII System Log

test_writable - system test if disk read only?

Normal Folder - location where videos are stored

  • 20170801 Folder - separate folder for each date
  • Video files naming example: 20170801150248_NM_0030_0001_1920_1080_25_04194304_AAAAAA_02.avi
  • 2017^08^01^ - Year^Month^Day
  • 15^02^48 - Hour^Minute^Second (from start?)
  • _NM_0030_0001_1920_1080_25_04194304_ Figure this out
  • AAAAAA_02 - Vehicle_Channel

Volume

Stkm volume.jpg

Set the playback volume via the remote. The default volume is 5.
Minimum volume: 1
Maximum volume: 10

Detailed Assembly Instructions

Hard Drive

Hard Disk Installation Detail

Stkm faceplate removal.jpg

Stkm HD Sled Removal.jpg

Step 1: Unlock the device with its key, and open the two side flaps on the front panel. Pull the front plate from the top down as shown.

Step 2: Pull the hard drive sled out by its attached ring

Stkm HD Sled Dissassembly.jpg

Stkm HD Sled Dissassembled.jpg

Step 3: Remove the six screws that hold the hard drive sled together carefully with a screwdriver. Once these screws are off the whole bottom plate should be removed.

Stkm SupportShelf Disassembly.jpg

Stkm HD Install.jpg

Step 4: Remove the two screws on the silver hard drive support shelf. Once these are removed pull the top of the shelf up as illustrated.

Stkm HD Installed.jpg

Stkm HD Screw install.jpg

Step 5: Slide the new hard drive into the enclosure making sure a solid connection is made with the hard drive.

Step 6: Fold the hard drive shelf back down into its resting position and secure the 4 hard drive mounting screws in place. These hard drive mounting screws come from the device's accessory pack

Stkm HD SupportShelf secure.jpg

Stkm HD Sled Assembly.jpg

Step 7: Apply the 2 foam pads to the inside of the cover

Step 8: Lock the hard drive shelf into place with the 2 securing screws from step 4

Step 9: Reinstall 6 Hard drive Sled cover screws that secure its bottom panel.

Stkm HD Sled Install.jpg

Step 9: Slide hard drive sled back into the D8 securely

Format Hard Disk Detail

Format SSD (15 seconds for 500GB)

Stkm DiskFormat Menu.jpg

Press the orange floppy disk icon to access the disk management settings

Stkm DiskFormat Selection.jpg

Select which disk you would like to format.

Note once formatted all data on this disk will be lost

Stkm DiskFormat Completion.jpg

Acknowledge that you would like to proceed with the format.

Wait for a format successful message. (this should take approximately 5 minutes for a 500GB hard drive)

USB Hard Drive Reader

Stkm hdd reader1.jpg

Stkm hdd reader2.jpg

USB Hard Drive Reader Connections

USB - can Power the Reader (why and when use the AC adapter?)

When Plugged into my Windows 10 system Deice Manager shows "Disk Drives > ASMT 2115 USB Device"

Power Jack - For use with 12volt 2AMP AC/DC Adapter Sold Separately from Stokam

Hard Drive Tray Connector - Plug in Hard Drive Tray here

USB Hard Drive Reader AC Adapter

Stkm hdd reader3.jpg

SIM Card Installation

Push the Eject button to the left of the SIM Slot with a pen and remove SIM Tray

Document SIM Number and Insert SIM Into Tray Such that it sits flush with the plastic tray

  • Note: Sim is held in under tension by plastic wedges inside the tray

Insert Tray into System, ensure it clicks in.

Stkm sim tray insertion 2.jpg

Stkm sim tray installation.jpg

Firmware Versions Changes/Notes

Displays system software version number

Update the picture with the current (new) version

Previous Versions

Stonkam Firmware release versions
Release Date Sys Version MCU Version Description/Notes
x x x x
7/2/19 20190605.5370 2019051516 Small Bug fixes
5/9/19 20190509.5112 2019042610 Created small FW Package
5/5/19 20190505.5073 2019042610 Fixed remote format and SSD coruptions
4/26/19 20190425.5031 2019041510 Add remote SSD format
4/17/19 20190417.4988 2019011010 Expanded debug logs for Stonkam
3/22/19 20190322.4888 2019011010 120 second delay on reporting, Sends SIM number
3/12/19 20190312.4791 2019011010 Support for VGA type Mother Board. Should work on both MB versions
2/22/19 20190221.4689 2019011010 Support for VGA type Mother Board. Should work on both MB versions
From Here Down HDMI Motherboards only!
10/10/18 20181010.3990 2018092910 Improved SSD support/reporting in alerts
9/4/18 20180904.3736 2018082810 Minor JSON Support change
8/31/18 20180829.3696 2018082810 Added JSON Support for auto reboot
8/13/18 20180808.3492 2018080310 Modified scheduled reboot, added day of week
7/18/18 20180718.3245 2018050719 Modified scheduled reboot, added day of week
7/9/18 20180709.3100 2018050719 Added timed reboot, GSM reset, Bad CRC!
6/14/18 20180614.2900 2018050719 Added remote configuration update capability
4/26/18 20180418.2631 2018030213 Added remote firmware update capability
3/26/18 20180324.1810 201802230021 Added Daylight Savings and Time update
1/29/18 20180129.xxx 2018xxxxx Added DNS for Server entry
8/22/17 20170822.1720 2017081808
8/17/17 20170816.1347 2017081615
8/7/17 20170807.0904 2017080215
8/1/2017 20170522.1746 TBD Original Version provided

Cellular connectivity notes

DVR cellular status messages

“modem signal drops, errors and does not reconnect” means signal is poor or no signal. so please double check if the sim card is well plug and with antenna and data there.

Engineer said there is an procedure when connect with cellular :

KO ERR -> OPEN ERR ->SIM/CPIN ERR -> CSQ ERR > CREG ERR> APN ERR ->DAILING ERR -> GET IP ERRor -> Success.

If there is any error, the status will go back to KO ERR, so could you take a picture of the last status where DVR goes back to KO error, then will be able to know the last failure spot.

LAN connection to D8

Set D8 IP address

configure a static IP (192.168.0.250 is set in our config file)

If IP not set by config file then: Open dvr display interface, revise the info in LAN interface (IP, Mask, Gateway, MAC) click OK to exit

Set computer to correct network segment (192.168.0.10)

1、connect DVR with network: dvr and computer in the same router or directly connect DVR to the computer. Computer and dvr should be in the same network segment.

2、Run cmd, see if you can ping the IP just set in DVR

If it works, You can continue to enter the command:

Telnet in DVR

Turn on Telnet Client in Windows 10 : Control Panel> Programs> turn windows features on or off

telnet 192.168.0.250 or //192.168.0.250 (IP just set in DVR)

(none) login: root

Password: sharpvision

Change UID

Only used if a serial number was duplicated. If you mess with it otherwise the warranty tracking will be messed up with Stonkam.

//After logging in, enter the following command:

echo xxxxxxxxxx > /etc/DeviceUid

//xxx.xxx.xxx.xxx (new uid)

Power off and reboot // reboot is necessary

3, check whether the UID number modified successfully.

4. new UID INFO (for example only!)

SerialNumber: 201035-424-00181 DeviceId: 1802230021 UserName: 201035 Password: 201035 Sever Ip: 183.233.190.23

SerialNumber: 201035-424-00182 DeviceId: 1802230022 UserName: 201035 Password: 201035 Sever Ip: 183.233.190.23
