Stonkam D8 Initial Configuration and Setup
Items Needed for Setup
- New D8 unit w/ accessory kit
 - New SSD
 - Power Supply
 - Power & Ground banana plugs to 8 pin power cable
 - A input/output medium, i.e.
- Remote control + 6 pin to RCA cable with RCA to USB adapter for viewing on Amcap software (yellow is video)
 - Remote control + D8 monitor
 - D8 Touch Screen monitor

 - SIM Card

NOTE: the 6 pin video out is labeled "Panel" on the D8
The D8 will turn on with the power supply, there is no intermediate power switch (contrary to the D4 DVRs).
Login
Admin Account
User Names are case sensitive
Default user name admin
Default password 123
After Config:
user name ADMIN
password IDRD8
Guest Account
The Guest account limits Menu Access to Playback and Volume only
Default "Guest User name : guest
Default Guest Password: 321
Change Guest to: BNSF
Password: 249805 (SB street address and area code)
Routine Setup
Follow along with a D8 Configuration Checklist.
Document UID / Serial Number
Each Stonkam DV424 has a 10 digit unique UID (Serial Number) Located in System>Info
Write this down on the traveler.
We will be using the last 8 digits as:
- Device ID (AC uses this as the DVR Serial Number)

- Printed on the Label which goes on the DVR

Example: UID 1707270002 will be Device ID 07270002
Install Batteries in Remote Control
From the accessory kit. We will not be sending a remote control for each DVR. We will ship some quantity to a loction and only these need to have batteries installed.
Install and Format Hard Drive
Click on the Floppy Disk Icon on main menu
Wait for a format successful message. (this should take approximately 5 minutes for a 500GB hard drive)
Upgrade Firmware and Verify
Get current version from AC
[|Stonkam D8 FW dv424_upgrade_20180425]
Upgrade of the firmware reformats the HDD/SDD because of a file system change
After the 20180127 update this should not happen anymore
Install Config File for vehicle type (Handler or Crane)
[|Stonkam BNSF Crane Config File 042618]
[|Stonkam BNSF Loader Config File 042618]
Install SIM Card Installation
Document the number on the Traveler
Keep the plastic card and note the vehicle number on it.
Set device/vehicle specific settings (tag device with vehicle number) (document on traveler)
- License No. (vehicle name)

- Device No. (UID - last 8 digits) (EX: 07270002)

- Time Zone – verify time correct for that zone

- Anything else specific to this one device?

Save Configuration to hard drive and keep a copy in the support folder
SSD
Export the configuration to the SSD
Thumb drive
Export the configuration to a Thumb drive.
Copy the config file to our system (Idrive Support> BNSF> Config_files> Location Name> vehicle_number_sv_xml.xml)
This way we have a record in case we need it.
Labels
Print 2 DVR S/N Labels (one for DVR and on for outside of the box)
- Label on top of DVR as shown (So Installer and Customer can identify the device for support)

- Vehicle Name

- DVR UID – (UID ALL 10 digits)

- SIM S/N

- Label Download (template requires Zebra Designer software to open)

Remove Film from Door Window
There is a protective film on the front door to protect the plastic
Remove Extra Items from DVR Kit
Remote Control (this will be shipped in the Location Items box)
Extra SIM Card Tray
Keys (ship one with the individual DVR and save the second at Idrive)
Monitor Cable (Male-Male)(this will be shipped in the Location Items box)
26 Pin I/O Cable
Pack DVR For shipping
- Camera and Cable Kits will be packed in separate box. (Only the DVR is vehicle specific however the Crane package will be different and marked accordingly)

- Each location will receive a Monitor, Monitor Cable, Extra Hard Drive, Hard drive reader(back ordered), A few remote controls and sets of keys.

Enter DVR into Admin Center
In the Manufacturing section select the "D4-DVR Production" Tab
- click Add

- Enter serial number (This is the Full "UID" and not the "Device Id")

- Click Add Device

- Assign Device to the Customer and Location

For BSNF adjust the Warranty to three years (add two years to the default warranty date)
Assign DVR to a Vehicle in Control Center
- Log into the "BNSF CC" (in RMA area)

- Go to Fleet Manager => Personnel => Add new person and fill in the appropriate info

- Go to Vehicles => Add new vehicle => Fill in the appropriate info

- Go to Devices/Drivers section => D4 Device => and click on the "..." button

- Select the serial number

- Click Assign

- Click Save Vehicle

LTI Tracking / Global Center
Notes:
A vehicle will not show up in the LTI interface until after the first connection
You can see is a device in AdminCenter:
- Support>Customer>Location>D4

- Click on the device serial number

- Select the "Health" Tab

Go to GPS Tracker => Operations => Manage Alerts
Add Alert
Click Add Alert
Alert Controls will expand
Alert Types
Select the alert type you want ( Camera Disconnected for BNSF)
Name the new Alert (Location Camera Disconnect)
Assign the Alert
Select the vehicle you want to assign the Alert(s) to.
Notifications
Click on Notifications tab "Envelop" button
Select an email you want to send this alert notification to
- Terminal Manager or appointed location manager (Should be in the pull-down menu if entered in CC)

- bnsfalerts@idriveglobal.com (distribution list for Idrive)

click on Save Alert and you are done!
Alert Filters
Our server filters out spurious alerts to limit false notifications:
RO set up these filters and never communicated the final version(s) of what is going on
This alert is from a crane that has the splitters attached to it and they lose power when the power to the crane monitor system is shut off but the cameras connected directly to the DVR remain on. rule that filters out alerts that have camera 1,2,3,4 functioning with video but 5,6,7,8 with video loss. Since the DVR remains on it will continue to check in at the programmed interval so comparing the video loss to the last check in time will not filter them out.
"the second filter which filters the alarms coming at the same time for more than 2 cameras"
"Few days ago, he also applied the one that filters “not recording” alarms"
"We are creating now an algorithm to filter these camera disconnects (in the end probably we need a machine learning one … ), if more than 2 cameras are received in a row having the same time(+/- few seconds) – is hard to believe that 3 cameras can fail or someone can disconnect all 3 at the same time(this should cover all installation alternative). We will discard all “not recording” alerts in case the “currant” status (at connection) reports recording. Also all alerts older than the previous connection time will be discarded"
Assign (name) SIM In Podsystems (Chrysta activates)
Assign and Activate SIMs at ship time. Give the list to Chrysta. Include SIM Serial number , BNSF Vehicle number, BNSF Location
Document the Customer, Location, Vehicle Name, SIM number and give to Chrysta
https://www.freedom2manage.com/user/login
Username:
Password:
Enter the SIM Card Number int the "Quick Filter" box
Click on the SIM Number to open the information page
Enter
- Name (customer / Location Vehicle) Example: BNSF SIG T0314

- Status - Change to active

- Bundle - Select the Bundle UKJ 10MB @ 0.70 OU 0.55USD Idrive Z0

- For BNSF D8 Alerts use: xxxxxxxx

- For Intermodal X2s use: xxxxxxxx

- ETC

- Date - Select date (what is this for?)

- Data Credit Limit (what are the amounts for the different types of clients)

- Alerts (what do we want here?)

- Alternate Email Alerts (create role account for distibution? Remove sean@idrive... as main email?)

Kit the other items for the vehicle (Cameras, Cables)
Main Menu
The Main Menu is Displayed by pressing Menu on the remote. If using a touch screen touch the bottom half of the screen. Entering any of these menus will stop the device from recording.
- 1)**Manually Control - Record, Play, Stop, FF, RW

- 2)**Playback - Search by date & Time

- 3)**Logs - System & Export Logs

- 4)*Display Mode - Switch Grid view from Channels 1-4, 5-8 or 1-8

- 5)**Configuration Settings - Record,Display, Network & System settings

- 6)**Storage - Manage SSD, SD, USB

- 7)**Volume - Playback Volume

Manually Control
Playback
A date marked in green indicates that there were videos recorded that day.
Click the day to view the list of enter the video files for that date
Choose the desired video and press the Play button.
- You can play single or multiple videos

- Multiple videos can be played in sequence and can shift into the next or the previous one.

Select and Play Videos
- Normal

- Event

- Capture

- Play

- All

- Exit

AL, I think "Capture" can be used to save the video to USB Stick. Might become more practical than swapping the hard drives. I have not tested this.
Logs
Used to keep a log of events in the system
Navigate to Menu->Setup->Log
System Log
Feature allows you to search the Systems Log of events on the machine
This log can be found on the hard drive in the "Log" folder
Video Loss now is shown in Syslog
- Disconnect camera #1 "Camera State Change:227"

- Reconnect camera #5 "Camera State Change:224"

- Disconnect camera #5 "Camera State Change:240"

- Reconnect camera #5 "Camera State Change:224"

Also no "Fault" light
Export Log
Use this feature to export the system log.
Log can be exported to SSD, SD, USB
Configuration Settings
Record
Picture is incorrect listed settings are correct
- Power On Rec ON

- Cyclic Rec. - Overwrite? ON

- Event Rec. OFF

- *Video Quality - Settings for Main Stream, Sub Stream, JPG

- *Record Channel - turn on/off recording for each channel

- Event Duration - 15 Seconds

- File Length - 15 Minutes

- Motion Sensitivity - OFF

- G-Force Sensitivity - OFF

- File Type - AVI

Video Quality
Main Stream
Resolution: D1(NTSC)
Bit Rate: 2Mbps
Frame Rate: 20fps
Sub Stream
Resolution: CIF(NTSC)
Bit Rate: 64Kbps
Frame Rate: 20fps
JPG
Frame Rate: LOW
Record Channel
Green means channel is enabled to record.
Loaders use channels 1,2,3,4
Cranes (mostly) use channels 1,2,3,4,5,6,7,8
Display
*Camera - Brightness, Contrast Etc for each Camera
*Cam Name - Name of Channel on Display
*Language - Set system Language
*Audio Out - Select Channel Audio to listen to
*Camera - Brightness, Contrast Etc for each Camera
*OSD - On Screen Display Information
*Menu On - How lon Menu is Displayed before logout
*Speed - Speed Settings
*GPS - GPS Location Information
*Mirror - Mirror the Camera Image
Camera
Individual Camera settings:
- Brightness

- Contrast

- Saturation

- Hue

Cam Name
Each camera has its own channel with its own "channel name".
Navigate to the display tab by hitting Menu->Setup->Display
Choose which camera name you would like to change by selecting its associated channel name. (8 letters max)
Loader Cam Names
- CH1 - CAB

- CH2 - L-Front

- CH3 - R-Front

- CH4 - Rear

Crane Cam Names
- CH1 - CAB

- CH2 - L-Front

- CH3 - R-Front

- CH4 - Far-Side

- CH5 - CH8 - these channels need to be mirrored for cranes

Language
To edit the language of the device access Menu->Setup->Display->Language
Select which language you want from the buttons presented. Languages available are English, French, German, Russian, Japanese, Italian, Austrian
Audio Out (N/A for BNSF)
This setting edits the output for the audio channel in split mode
Navigate to this setting by selecting Menu->Setup->Display->Audio Out
Select which camera's audio you would like to output.
OSD
OSD controls what information gets overlayed on the video of each camera.
Navigate to this setting by selecting Menu->Setup->Display->OSD
- Time - ON

- License - ON

- Camera Names - ON

Menu On
Sets the duration of time the menu will display on the screen.
Navigate to this setting by selecting Menu->Setup->Display->Menu On
Settings: 30, 60, 120 seconds, or always on. ::*Time - 60 Seconds
The menu lock setting will lock the menu to be password protected.
A password is needed to change this setting
- Menu Lock - ON

Speed
Allows you to change the source of the displayed speed to either the GPS or the vehicle speedometer as well as the units of speed to be either kph or mph
Navigate to this setting by selecting Menu->Setup->Display->Speed
GPS
Displays information of latitude/longitude, detectable satellites, connected satellites, speed, and time
Navigate to this setting by selecting Menu->Setup->Display->GPS
Mirror
Mirrors the video output on the selected camera. Configurable to each camera
Navigate to this setting by selecting Menu->Setup->Display->Mirror
Network
*Lan - Lan Settings
*Wifi - Wifi Settings
*Cellular - Cellular Settings
*Status - Networks Status
*Server - Server Settings
*FTP - FTP Settings
LAN
Defaults:
- IP Address 192.168.100.188 set to 192.168.0.250

- Mask 255.255.255.0

- Gateway 192.168.100.1 set to 192.168.0.1

- MAC Add: 7e:97:15:xx:xx:xx

Notes:
I can ping it but not login. There does not appear to be any access from the network only connectivity with a local server
WiFi
N/A - Optional
Cellular
- Cellular - ON

- Standard - WCDMA

- APN - data641003

- Access No. - *99#

- User Name - BLANK

- Password - Blank

Status
Displays information on:
- Lan IP address
 - MAC Address
 - 3G/4G Network Status
 - 3G/4G Signal Strength
 - Wifi Network Status
 - Wifi IP Address
 - Wifi Signal Strength
 - Server Status
 - Network Connectivity

Server
Server Address: lti-api.idriveglobal.com
DVRs shipped prior to 1/29/18 did not support DNS for Server identification. The following IP address was used:
Server IP 34.194.3.17 port 8898
FTP
System
*User - User Password
*Device - Vehicle, Device, Path information
*Schedule - Timed Recording
*Exception - Buzzer On/Off and duration
*Acc -
*Alarm -
*Update -
*Config -
*Info -
User
Device
License No. - Default:(AAAAAA) Set to Vehicle Name
Device ID - Default:(BBBBBB) Set to UID(last 8 Digits only) Example: 07270002
Path No. - Default (CCCCCC) Not Used (removed in later FW releases)
From Stonkam 8/11/17 "it is a feature reserved for adding bus number in the future if the customer needs"
Date & Time
Set for customer location

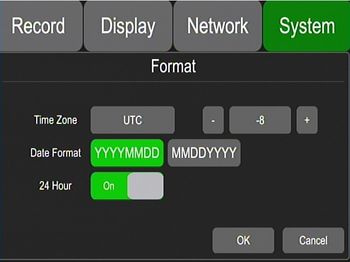

Timezone: Set to PST is -8

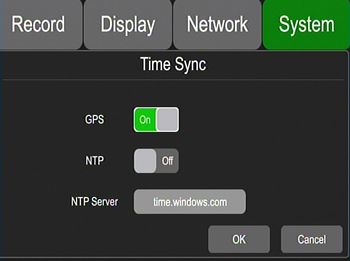

Time Sync: Set to GPS on NTP off
Enable: Set to ON
Start time / End time: Set to As Shown
Schedule
Used to schedule up to 4 recording tasks.
Recording settings include a start & end time as well as day of the week to record.
Note: Recordings are permitted to overlap
Exception
Settings to configure a buzzer when certain errors occur.
Example: Buzzer when camera becomes disconnected
ACC
Displays:
- Current voltage of the DVR
 - Shutdown voltage- If voltage < shutdown voltage then dvr shuts down, powers back on only when voltage exceeds shutdown voltage
 - ACC Delay- Continued recording after ACC is disconnected. Options are 5,30,60 seconds

FW 20180117 changes ACC Delay values to 5s, 60s, 30min, 60min
Alarm
Update
Process takes ~ 3 Minutes
Ensure you are using the latest FW version (Downloads section of A/C)
Eric's note: USB would not mount unless first formatted in the D8. Windows will see the D8 formatting as something it needs to "scan and fix". Do not "fix" this.
Copy the firmware to USB stick or SD card root directory.
Insert the USB Stick into the DVR.
Either:
- Reboot the DVR or

- Navigate to Menu -> Setup -> System -> Update> Hit OK

Wait for Update Success!
Verify that the update was successful by Menu -> Setup -> System -> Info
Compare the current version to the desired version.
Upgrade Notes
New FW dv424_upgrade_201801171957 received 1/16/18. Mark's notes:
Upgrading no longer deletes the configuration files. However you must remove the thumb drive after the update and before it reboots or else it will update again and again and...
Upgrading requires reformat of Hard drive and all data will be lost!!!
Updates after 20181017 will not format the HDD/SSD since the filesystem changes have already been made
Currently, the upgrade package is deleted from the USB stick after the upgrade process is finished. To prevent having to recopy the firmware to the USB stick rename the file.
Example of Firmware Name: “dv424_upgrade_201801171957”
Change Name to : “dv424_upgrade_never_rename”
Step 2:Copy the package to USB disk or SD card root directory, and insert it to DVR.
Step 3:Power off the DVR and reboot it, then it will auto upgrade. Or in the menu Menu -> System -> Update, click OK to confirm to upgrade. Both method can start the upgrade process.
Stonkam Notes:
The flash size of our DVR is 58M. it is normal for the upgrading package when is less than 58M. The actual size of the upgrading package depends on how much it will be upgraded.
The DVR will start upgrading only after the success calibration of the package files. if the calibration fail, DVR can not upgrade.
There is a debug interface on DVR, so even something wrong with firmware, can recover DVR through the debug interface, so it will not be a brick.
Config
Note: When you select Import or Export it executes with "OK" you think it is hung but is working
Import
Insert the USB with the appropriate configuration file sv_xml.xml in its root directory
Eric's note: filename must match exactly, you might have to rename if downloaded from the AC
Select the import button
Export
Select Export, Select location (SSD or USB or SD)
Saves sv_xml.xml to location
Storage
Filesystem Structure
Log4Gui - ASCII System Log
test_writable - system test if disk read only?
Normal Folder - location where videos are stored
- 20170801 Folder - separate folder for each date

- Video files naming example: 20170801150248_NM_0030_0001_1920_1080_25_04194304_AAAAAA_02.avi

- 2017^08^01^ - Year^Month^Day

- 15^02^48 - Hour^Minute^Second (from start?)

- _NM_0030_0001_1920_1080_25_04194304_ Figure this out

- AAAAAA_02 - Vehicle_Channel

Volume
Set the playback volume via the remote.  The default volume is 5.
Minimum volume: 1
Maximum volume: 10
Detailed Assembly Instructions
Hard Drive
Hard Disk Installation Detail
Step 1: Unlock the device with its key, and open the two side flaps on the front panel. Pull the front plate from the top down as shown.
Step 2: Pull the hard drive sled out by its attached ring
Step 3: Remove the six screws that hold the hard drive sled together carefully with a screwdriver. Once these screws are off the whole bottom plate should be removed.
Step 4: Remove the two screws on the silver hard drive support shelf. Once these are removed pull the top of the shelf up as illustrated.
Step 5: Slide the new hard drive into the enclosure making sure a solid connection is made with the hard drive.
Step 6: Fold the hard drive shelf back down into its resting position and secure the 4 hard drive mounting screws in place. These hard drive mounting screws come from the device's accessory pack
Step 7: Lock the hard drive shelf into place with the 2 securing screws from step 4
Step 8: Reinstall 4 Hard drive Sled screws that secure its bottom panel.
Step 9: Slide hard drive sled back into the D8 securely
Format Hard Disk Detail
Format SSD (15 seconds for 500GB)
Press the orange floppy disk icon to access the disk management settings
Select which disk you would like to format.
Note once formatted all data on this disk will be lost
Acknowledge that you would like to proceed with the format.
Wait for a format successful message. (this should take approximately 5 minutes for a 500GB hard drive)
USB Hard Drive Reader
USB Hard Drive Reader Connections
USB - can Power the Reader (why and when use the AC adapter?)
- When Plugged into my Windows 10 system Deice Manager shows "Disk Drives > ASMT 2115 USB Device"

Power Jack - For use with 12volt 2AMP AC/DC Adapter (for use with Laptop or why?)
Hard Drive Tray Connector - Plug in Hard Drive Tray here
USB Hard Drive Reader Connections
Green (upper LED) -
Red (lower LED) - Power On
USB Hard Drive Reader AC Adapter
SIM Card Installation
Push the Eject button (shown in yellow) to the left of the SIM Slot with a pen and remove SIM Tray
Document SIM Number and Insert SIM Into Tray Such that it sits flush with the plastic tray
- Note: Sim is held in under tension by plastic wedges inside the tray

Insert Tray into System, ensure it clicks in.
Firmware Versions Changes/Notes
Displays system software version number
Update the picture with the current (new) version
Latest Version 4/26/18 is:
Added remote update capability
- SYS Version: ID_20180418.2631

- MCU Version: 2018030213

- UID : Depends on DVR

Version (Beta) 3/26/18 is:

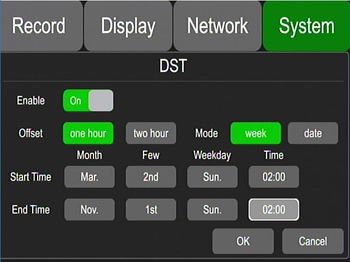

Added Daylight Savings and Time update
- SYS Version: ID_201803241810

- MCU Version: 201802230021

- UID : Depends on DVR

Version 1/29/18 is:
Added DNS for Server entry
- SYS Version: ID_20180129xxxx

- MCU Version: 2018xxxxx

- UID : Depends on DVR

Version 8/22/17 is:
- SYS Version: ID_201708221720

- MCU Version: 2017081808

- UID : 1707270002

Version we received on 8/17/17 is:
- SYS Version: 201708161347

- MCU Version: 2017081615

- UID : 1707270002

Version we received on 8/7/17 is:
- SYS Version: 201708070904

- MCU Version: 2017080215

- UID : 1707270002

Original Installed version was:
- SYS Version:201705221746

- MCU Version: Not shown

- UID : 1705080007

LAN connection to D8
Set D8 IP address
configure a static IP (192.168.0.250 is set in our config file)
If IP not set by config file then: Open dvr display interface, revise the info in LAN interface (IP, Mask, Gateway, MAC) click OK to exit
Set computer to correct network segment (192.168.0.10)
1、connect DVR with network: dvr and computer in the same router or directly connect DVR to the computer. Computer and dvr should be in the same network segment.
2、Run cmd, see if you can ping the IP just set in DVR
If it works, You can continue to enter the command:
Telnet in DVR
Turn on Telnet Client in Windows 10 : Control Panel> Programs> turn windows features on or off
telnet 192.168.0.250 or //192.168.0.250 (IP just set in DVR)
(none) login: root
Password: sharpvision
Change UID
Only used if a serial number was duplicated. If you mess with it otherwise the warranty tracking will be messed up with Stonkam.
//After logging in, enter the following command:
echo xxxxxxxxxx > /etc/DeviceUid
//xxx.xxx.xxx.xxx (new uid)
Power off and reboot // reboot is necessary
3, check whether the UID number modified successfully.
4. new UID INFO (for example only!)
SerialNumber: 201035-424-00181 DeviceId: 1802230021 UserName: 201035 Password: 201035 Sever Ip: 183.233.190.23
SerialNumber: 201035-424-00182 DeviceId: 1802230022 UserName: 201035 Password: 201035 Sever Ip: 183.233.190.23
