ICV D8 Initial Configuration and Setup

From Idrive
Jump to navigation Jump to search

ICARvisions D8 Initial Configuration



Configure/Document Hardware


Document Model Number, Serial number, SIM Card number

Record them where? A/C, AWS, Pod systems - need RO support for this.


Hard Drive Installation/Configuration

Install SSD in in the D8 tray ans secure with the 4 supplied screws



Format Hard drive EXT3 (Linux filesystem)

  • Format the hard drive in the D8 Tools>Format (an unformatted HDD will show 0MB capacity)

500GB drive formats in less than 3 minutes


Install Batteries (not included)in the remote control

  • requires 2 AAA batteries


Plug in the power supply harness

Power connector's plastic is keyed the same as Easystorage(D4)as well as the VisionMaster D8 and but the pinouts are different!

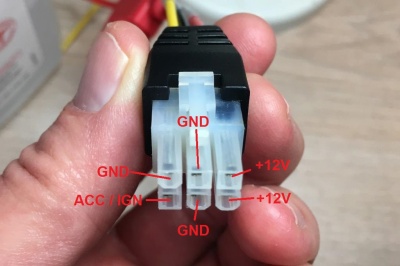

Icv8 power conn.jpg


Connect a monitor or Computer

Plug supplied Monitor cable into the front of the D8

Connect Monitor cable to either:

  • External Monitor (Connect Yellow for video and black for monitor power)
  • For Laptop connection use StarTech USB to Svideo Video adapter with AMCAP Capture software (Connect yellow video connector requires Male to Male RCA adatpter)
  • plug Cat5 cable into device,Use Web browser - navigate to 192.168.0.250 ( need to verify if this is default with a new D8)




Remove Sensor Cable and other unused options

The cable will not be used by BNSF. Remove it and keep at Idrive in case needed in the future



System Configuration

Power up the device


Logging into D8 System

Notes:

  • when you login recording will stop
  • If you disconnect AMCAP or Monitor the user remains logged in so it will not record until the session times out.


Press the "Login" Button on the remote.

Default login: Admin user default passwd 888888


For Configuration: User name and Passwords limited to 6 letters/numbers max

*I propose we change "Admin" user to "Idrive" with a password of "idradm" . This login would be used by Idrive Support only.

I renamed the user on my system but cannot change the password!


*Create a user called BNSF for the location manager to use. This will not have full admin permissions, only what we would allow them to do what they need to. We need to identify what they need and how to set the permissions. - Mark

  • View, Copy videos
  • Next item
  • Next item



Setup Menu

The Setup Menu has 8 options

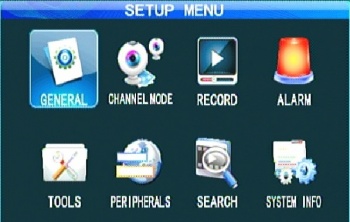

Icvd8 setup Menu.jpg

*General - Basic info for: Device, Vehicle, User, Network, Display, OCD

*Channel Mode -

*Record - Recording Settings

*Alarm - Alarm Settings

*Tools -

*Peripherals - PTZ, Cellular, Wifi setup

*Search - Search for videos by Date/Time Etc.

*System Info


General

The Basic setup menu has 6 options

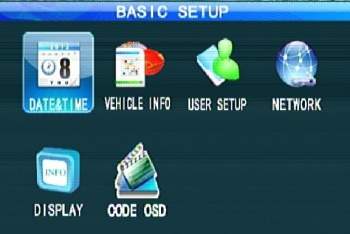

Icvd8 basic setup.jpg

*Date & Time - Date, Time, Daylight Savings, Timezone, Power Modes Etc.

*Vehicle Info - Serial Number, Device_Number SIM- Number, Vehicle Number

*User Setup - User Management

*Network - Network and server settings

*Display - On screen display, video out settings

*Code OSD - Per channel screen/video display







General>Date & Time

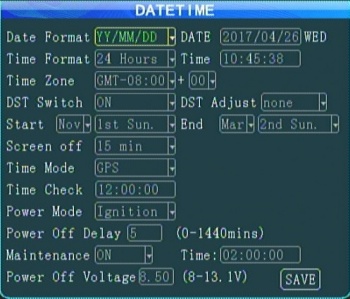

Icvd8 date time.jpg
  • Date Format
  • Time Format
  • Daylight Savings Settings
  • Time Mode - GPS
  • Power Mode - Ignition











General>Vehicle Info

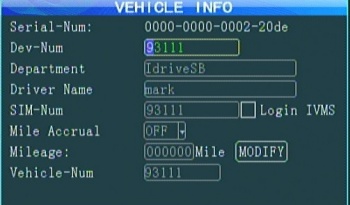

Icvd8 vehicle info.jpg

Serial number of Device (Hex so not suitable for device number) Example 0000-0000-0002-20de

*Dev-Num - must be 5 digits to integrate with server

  • Department - Optional
  • Driver Name - Optional

*SIM-Num - field is only 12 digits long but SIM cards are 19 digits long. - figure it out

  • Login IVMS check box - must Un-Check to use SIM Card
  • Mile Accrual - N/a
  • Mileage - N/A

*Vehicle-Num - vehicle name. can take letters as well as numbers. Set on server?



General>User Setup

Icvd8 user setup.jpg

Add/Remove users. Only the Admin User exists in the received device.

*Setup a BNSF User.

* change "Admin" to "Idrive" and non-defaut password?











General>Network

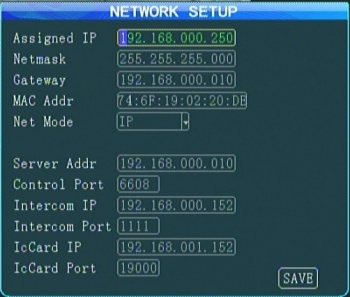

Icvd8 network setup.jpg

For Wired Cat5 connection ONLY:

  • IP Address
  • Netmask
  • Gateway
  • MAC Address


For Wired, Wireless and Cellular connections:

  • Net Mode - search for Server by IP address or DNS
  • Server Address - either IP Address or DNS Ex: dvr.idriveglobal.com
  • Control Port - Must match the port of the "Gateway Server"


Other Options: Intercom & IcCard - N/A




General>Display

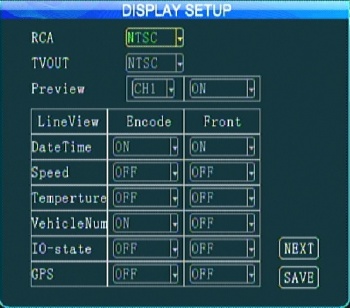

Icvd8 display setup.jpg



















General>Code OSD

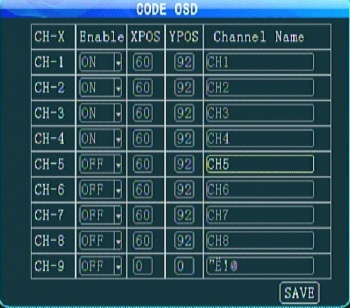

Icvd8 code osd.jpg

Controls the text shown on screen/recordings

For BNSF each vehicle type will have different settings:

*SideHandler
*Chassis Handler
*Crane











Channel Mode

Channel Mode Settings

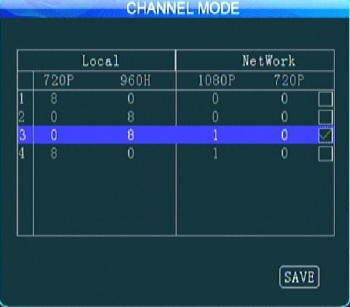

Icvd8 channel mode.jpg



















Record Settings

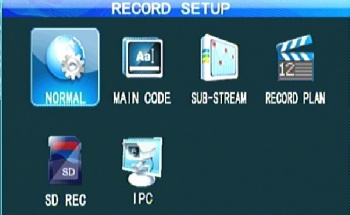

Icvd8 record setup.jpg

*Normal - Recording Basic Setup

*Main Code -Channels setup

*Sub-Stream -

*Record Plan- Timed recording schedule

*SD Rec - Set backup to SD Card?

*IPC - IP Camera Settings






Record>Normal

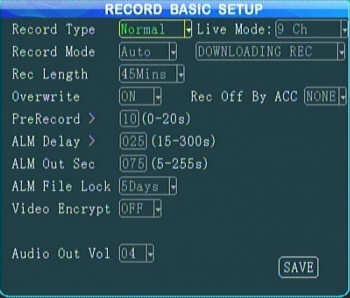

Icvd8 record normal.jpg

*Record Type - Normal or "I-Frame"

*Record Mode- Auto, Timer, Alarm (use Auto to record on power on)

*Record Length - amount of time in each file 15/30/45/60 Minutes 30 minutes Discuss preference

*Overwrite - record over old videos when <2GB left on hard drive ON

Rec Off By ACC -

*PreRecord - add video before alarm into alarm record. 0-20 seconds 10

*ALM Delay - after alarm clears how much time recorded into alarm record. 15-300 seconds 25

*ALM Out Sec - continuous output time for alarm wire - N/A

*ALM File Lock - lock alarm file from deletion for 1/3/5/7/10/15/30/45 days 5

*Video Encrypt - requires a password be used when playing back a file on the player OFF

*Audio Out Vol - output volume N/A

*Live Mode - Number of channels shown on screen 9 for Cranes, 6 for Handlers/Chassis

"Downloading Rec" - sort it out...


Record>Main Code

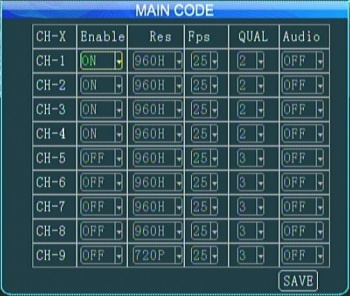

Icvd8 record main.jpg

Enable only the channels for the number of cameras in the vehicle. (3 config files for BNSF)

Input needed on Res/Qual selection. Al?
















Record>Sub-Stream


Record>Record Plan


Record>SD Rec


Record>IPC


Alarm Settings

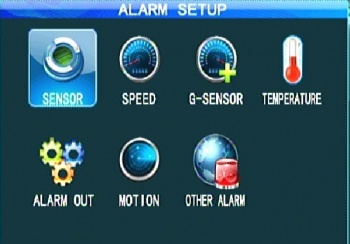

Icvd8 alarm setup.jpg

*Sensor - Configure & Assign input for wired alarms

*Speed - Configure speed alarms

*G-Sensor - Configure accelerometer alarms

*Temperature - Configure temperature alarms

*Alarm Out - Configure & Assign output for wired alarms

*Motion - Configure motion sensor alarms

*Other Alarms - Configure stationary or Fatigue alarms





Alarm>Sensor


Alarm>Speed


Alarm>G-Sensor


Alarm>Temperature


Alarm>Alarm Out


Alarm>Motion


Alarm>Other Alarm


Tools Settings

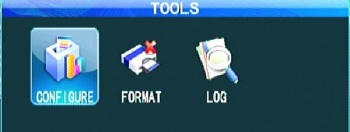

Icvd8 tools menu.jpg

*Configure - Import, Export, Default Config, Upgrade Logo

*Format - Format media

*Log Search - Search System/Alarm Logs





Tools>Configure

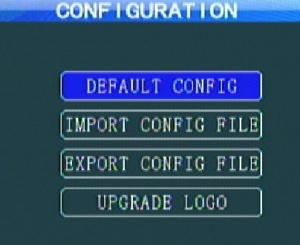

Icvd8 tools config.jpg

*Default Config - restore all settings to factory default


*Import Config File - Import configuration Settings From USB Stick

Insert USB Stick with config file and Import (parameter.conf file is not ASCII)


*Export Config File - Export Configuration Settings

Insert USB Stick and export.
If no USB Stick the file is exported to the hard drive


*Upgrade Logo - Import Logo (Boot Logo & Upgrading Logo)

  • Each Logo needs an Image size of 720x576 pix, Smaller than 256k, jpg format
  • required names: loading.jpg & upgrading.jpg
  • If images are on the USB stick at configuration time they should load



Tools>Format

500MB drive formatted in 2:45


Tools>Log Search

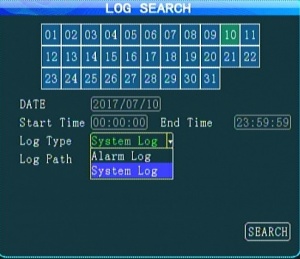

Icvd8 log search.jpg

















Peripherals Settings

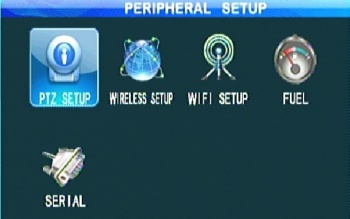

Icvd8 peripherals setup.jpg

*PTZ Setup -

*Wireless Setup - 3G/4G Setup

*Wifi Setup - Wifi Setup

*Fuel -

*Serial - Com Port setup








Peripherals>PTZ Setup


Peripherals>Wireless Setup

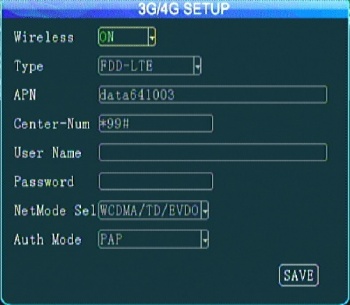

Icvd8 4g setup.jpg

















Peripherals>Wifi Setup


Peripherals>Fuel


Peripherals>Serial


Search Settings

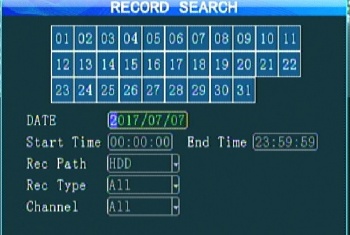

Icvd8 search menu.jpg














System Info














Configure

Firmware upgrade with USB Stick

1.Device must switch off power disconnect the power source before upgrading;

2.Extract the rar file, copy the .crc file to a USB flash memory FAT32 format, insert the flash memory to the MDVR USB port.

3.Power on the MDVR(connect the power), it will update automatically once the MDVR starts up. and the monitor will display "upgrading..."

4.Device will automatically restart when the upgrade is complete.

Attention: Upgrade will need about 3-5 minutes. Make sure power connecting all the time during upgrading



Firmware upgrade with SD Card

1.Device must switch off power;

2.Decompress the rar file, copy the .crc file to a SD card, and insert the SD card to the MDVR SD card port.

3.Power on the MDVR, it will update automatically once the MDVR starts up. and the monitor will display "upgrading..."

4.Device will automatically restart when the upgrade is complete.

Note: upgrade will need about 3 minutes. Make sure power connecting all the time during upgrading.
