New D4M (4/17/19) Initial Configuration and Setup
Idrive D4M Configuration

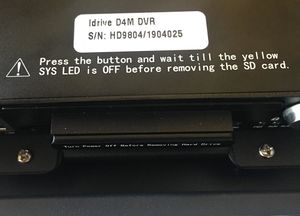

Record Serial Number
Serial number is located on the bottom of the D4M.
- Remove D4M from the Security Box
- Record Serial number
- Print Label and afix to the top of the D4M
- Enter Serial Number into Admin Center.
- AC> Manufacturing >D4-DVR Production Tab
- Click on ADD and enter the S/N
- Select Item Type IDRDVRD4HD
Install Hard Drive/SSD
Use the 4 screws in the plastic bag with the keys to secure the SSD in the carriage

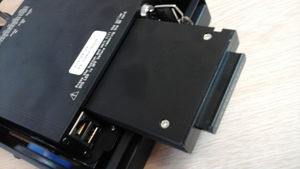

Install the Hard Drive Sled into the D4M
Setup the D4 for configuration

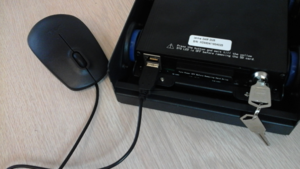

- 1)*Plug in a Mouse into the USB port on the left hand side of the Front Panel (no Remote Control with the D4M)
or if your monitor has an open HDMI input the image will be full screen and the Mouse will be easier to point on a large Desktop 21" Monitor

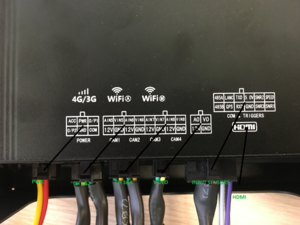

- In the Rear Panel>
- 1)*Plug in the Power Cable
- 2)*Plug in the Monitor Cable
- 3)*Plug in the Camera Cable
- 4)*Turn power supply ON
- 5)*Turn Key ON
- 6)*Select Main Menu
- 1)*Confirm that the Alarm Wire SNR1 (Grey wire below the purple wire on the black Molex plug) triggers Cam Ch#2 to full screen when connecting the Grey wire to 12VDC
NOTE: this will only function after the CFG is loaded to the D4M
see pic on right after cfg is loaded
Click the Right Mouse Button For Options
- 1)*Main Menu - DVR Configuration Options
- 2)*SingleScreen - Display one Camera on the Monitor
- 3)*MultiScreen - Display all 4 cameras on the monitor
- 4)*UpScreen - Figure it out
- 5)*DownScreen - Figure it out
- 6)*Screen Save - Save the current screen configuration as Default
- 7)*PTZ
Verify Correct Firmware version
Main Menu> System> System Info
Current Release V206-2019/4/12-10:11:124
Upgrade Firmware if needed
- Obtain Latest Firmware Version from AdminCenter (if we receive one)
- Place the Firmware on a SD Card (USB Port is in use for the mouse)
- Insert the SD card into the DVR
- Main Menu> System> System Upgrade> Browse and select file and click OK
Import Idrive Default Configuration
*Download the Latest Config File hidvr.zip
- Place the Config File on a SD Card (USB Port is in use for the mouse)
- Insert the SD card into the DVR
Note: if the SD has been used in another Deck it might have 2 additional files... if so only select the Hidvr.cfg

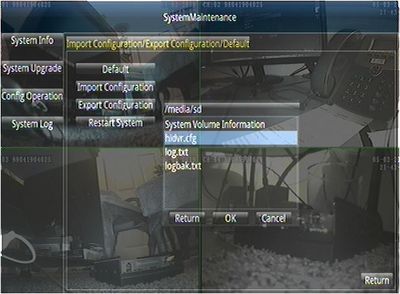

- Main Menu> System> Config Operation>
- Import Configuration Browse and select file "hidvr.cfg" and click OK
Note: this will only take a second and may or may not appear to change the screen, but it is finished.
Hit return on the bottom to return to the previous menu
Verify Config and customize Settings
- Enter the serial number for the D4M into the “LICENSE ID”
- Menu> Mobile> Motor> License ID
- Set the Customer's Time Zone
- Menu> Setting> Date/Time> Timezone
- Set the Customer's Time
- Menu> Setting> Date/Time> Set Time
- Set the Customer's Daylight Savings Time
- Menu> Setting> DST Setting> USA
- Note Selecting USA sets DST Correctly
IMPORTANT! Click on APPLY before leaving screen or restarting
- Turn Key OFF
- Remove SD Card
Format the SSD / Hard Drive
- Install the hard drive carriage into the D4M
- Turn the key ON
- Format the SSD/Hard Drive Menu> Storage> Disk Info> Format
- The Format Button is at the bottom but does not display in AMCAP
- Push record and verify that it can write to the hard drive.
- Push stop
- Test all camera ports with a working camera to ensure that they all work.
- Turn the Key and Power supply off.
- Box up unit with serial number on the outside of the box

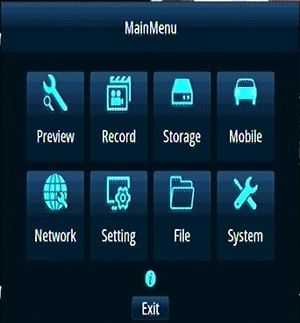

Main Menu
The Main Menu is Displayed by right clicking the USB mouse .
- 1)**Preview - Camera Setting, Motion Setting
- 2)**Record - Video program, parameters and related configuration
- 3)**Storage - Hard disk information and formatting
- 4)**Mobile - Power, motor, GPS, G-sensor etc.
- 5)**Network - 3G/4G, LAN, Server related configuration
- 6)**Setting - User, alarm system parameters, such as configuration
- 7)**File - The captured image display and operation
- 8)**System - System info, upgrade management, etc.
Preview

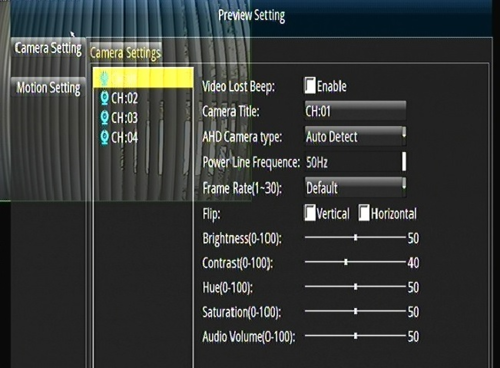

Camera Settings
Each channel set separately
- 1)*Video Lost Beep - Enable for beep when video is lost OFF
- 2)* Camera Title - DEFAULT(CH:0#)?
- 3)*AHD Camera Type - AUTO DETECT
- 4)*Power Line Frequence - ?
- 5)*Frame Rate - DEFAULT (30)
- 6)*FLIP - Mirror horizontal or vertical OFF,OFF
- 7)*Brightness * DEFAULT (50)
- 8)*Contrast - DEFAULT (40)
- 9)*Hue - DEFAULT (50)
- 10)*Saturation - DEFAULT (50)
- 11)*Audio Volume - DEFAULT (40)
- 12)*Auto Black-and-White - At night switch to Black and White mode OFF
- 13)*FrameRate Down - lower frame rate at night OFF
- 14)*IR LED Light - Only if supported by the camera AUTO
- 15)*LED Status Indicator - OFF
Copy To, Apply, Return Buttons not shown in AMCAP

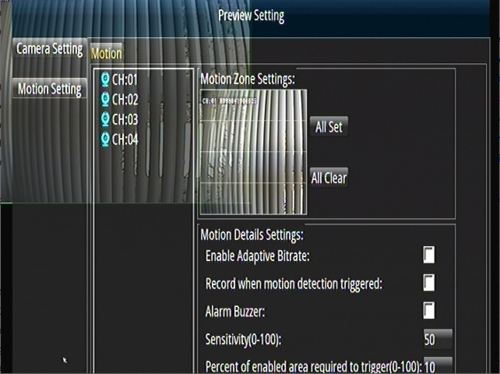

Motion Settings
Each channel set separately
- 1)*Motion Zone Settings All Clear
- 2)* Enable Adaptive Bit rate Default
- 3)* Record when motion detection triggered Default
- 4)* Alarm Buzzer Default
- 5)* Sensitivity(0-100) Default(50)
- 6)* Percent of enabled area required to trigger (0-100) Default(10)
Copy To, Apply, Return Buttons not shown in AMCAP

Record
- 1)* Resolution - DEFAULT(BASIC,2/3D1)
- 2)* Bitrate(Kbps) - DEFAULT(200)
- 3)* Frame Rate(1-30) - DEFAULT(30)
- 4)* Real Frame Rate - 30
- 5)* File Length(Minutes) - 5 (Set 5 on all 4 Channels)
- 6)* Record with Audio - YES (Set YES on all 4 Channels)
- 7)* Record Mode - DEFAULT(AUTO)
- 8)* Size(MBytes/hour) - DEFAULT(710)
- 9)* Camera Status - DEFAULT (Monitored,OK)
- 10)* Record Status - DEFAULT (Monitored,Recording)
- 11)* Stop All Stop - Do not press, unless intending to stop recording.
- 12)* Record File Encryption - DEFAULT(Blank)

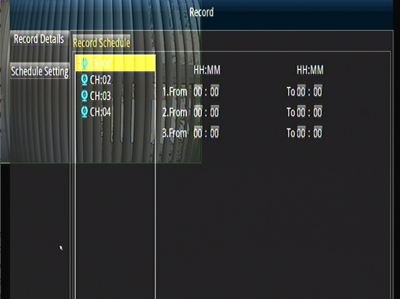

Record Schedule
- 1)* HH:MM HH:MM Leave this section blank - DEFAULT
Clear, Copy To, Apply, Return Buttons not shown in AMCAP

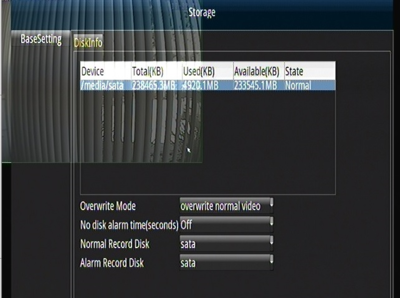

Storage
- 1)* Overwrite Mode - DEFAULT(Overwrite normal video)
- 2)* No disk alarm time(seconds)) - CFG sets to 60 seconds (ON)
- 3)* Normal Record Disk - DEFAULT(sata)
- 4)* Alarm Record Disk - DEFAULT(sata)
- 5)* Format - Use Format Only at Initialization of SSD
Format, Refresh, Apply, Return Buttons not shown in AMCAP
Mobile

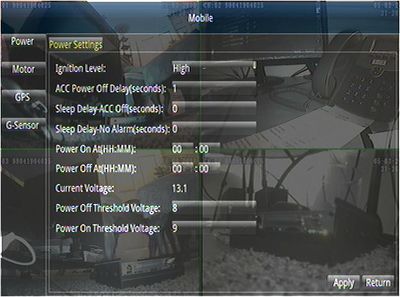

Power
- 1)* Ignition Level - DEFAULT(High)
- 2)* ACC Power Off Delay(seconds)) - CFG set to 1 Second
- 3)* Sleep Delay-ACC Off(seconds) - CFG set to 0
- 4)* Sleep Delay-No Alarm(seconds) - CFG set to 0
- 5)* Power On at(HH:MM) - 00:00
- 6)* Power Off at (HH:MM) - 00:00
- 7)* Current Voltage - 13.3 (monitored)
- 8)* Power Off Threshold Voltage - Set to 8VDC
- 9)* Power On threshold Voltage - Set to 9VDC

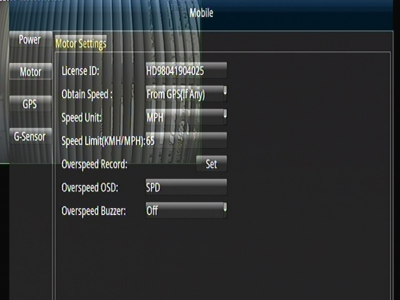

Motor
- 1)* License ID - ENTER S/N
- 2)* Obtain Speed - DEFAULT(From GPS(If any))
- 3)* Speed Unit - MPH
- 4)* Speed Limit - 65
- 5)* Overspeed Record - DEFAULT
- 6)* Overspeed OSD - SPD
- 7)* Overspeed buzzer - Off
Apply, Return Buttons not shown in AMCAP

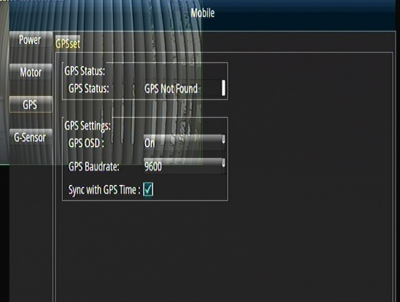

GPS
- 1)* GPS Status - DEFAULT(Monitored, Not Found)
- 2)* GPS OSD - DEFAULT(On)
- 3)* GPS Baudrate - DEFAULT(9600)
- 4)* Sync with GPS time - Check
Apply, Return Buttons not shown in AMCAP

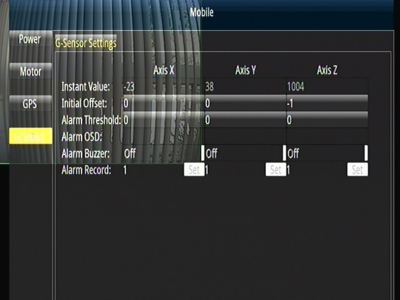

G-Sensor
- 1)* Instant Value - DEFAULT(Monitored)
- 2)* Initial Offset - DEFAULT(0,0,-1 TBD)
- 3)* Alarm Threshold - DEFAULT(0,0,0 TBD)
- 4)* Alarm Buzzer - DEFAULT(TBD)
- 5)* Alarm Record - DEFAULT(TBD)
Correction, Refresh, Apply, Return Buttons not shown in AMCAP
Network

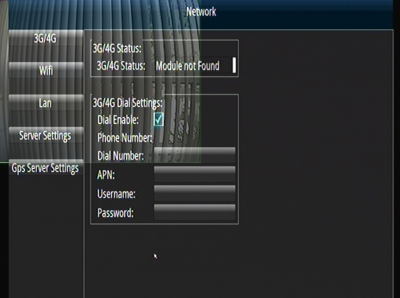

- 3G/4G
- 1)* 3G/4G Status - DEFAULT(Monitored,Module Not Found)
- 2)* Dial Enable - DEFAULT(Check))
- 3)* Dial Number - DEFAULT(Blank)
- 4)* APN - DEFAULT(Blank)
- 5)* Username - DEFAULT(Blank)
- 6)* Password - DEFAULT(Blank)
Apply, Return Buttons not shown in AMCAP

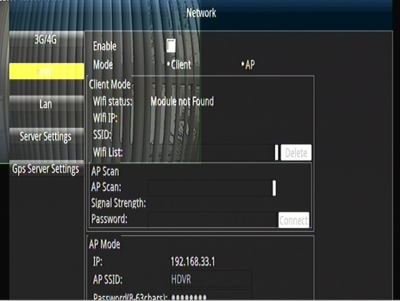

- WiFi
- 1)* Enable - DEFAULT(Uncheck)
- 2)* Mode - DEFAULT(Do not Select)
- 3)* WiFi Status - Monitored, Module not found
- 4)* WiFi IP - DEFAULT(Blank)
- 5)* SSID - DEFAULT(Blank)
- 6)* WiFi List - DEFAULT(Blank)
- 7)* AP Scan - DEFAULT
- 8)* Signal Strength - DEFAULT
- 9)* Password - DEFAULT
- 10)* IP - DEFAULT(192.168.33.1 TBD)
- 11)* AP SSID - DEFAULT(HDVR, TBD)
- 12)* Password - DEFAULT
Apply, Refresh, Return Buttons not shown in AMCAP

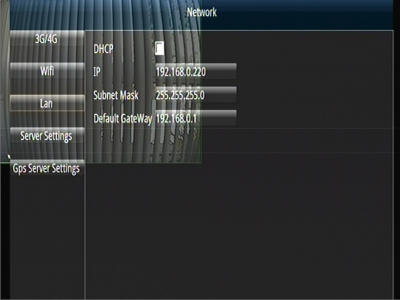

- LAN
- 1)* DHCP - DEFAULT(Uncheck)
- 2)* IP - DEFAULT(192.168.0.220)
- 3)* Subnet Mask Status - DEFAULT(255.255.255.0)
- 4)* Default Gateway - DEFAULT(192.168.0.1)
Apply, Return Buttons not shown in AMCAP

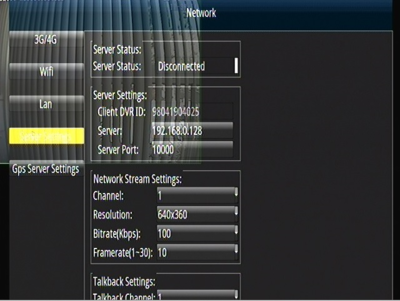

- Server Settings
- 1)* Server Status - DEFAULT(Monitored, Disconnected)
- 2)* Client DVR ID - DEFAULT(S/N)
- 3)* Server - DEFAULT(192.168.0.128)
- 4)* Server Port - DEFAULT(10000)
- 5)* Channel - DEFAULT(1)
- 6)* Resolution - DEFAULT(640x360)
- 7)* Bitrate(Kbps) - DEFAULT(100)
- 8)* Framerate(1-30) - DEFAULT(10)
- 9)* Talkback Channel- DEFAULT(1)
Apply, Return Buttons not shown in AMCAP

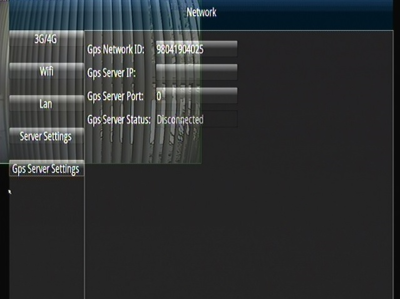

- GPS Server Settings
- 1)* GPS Network ID - DEFAULT(S/N)
- 2)* GPS Server IP - DEFAULT
- 3)* GPS Server Port - DEFAULT(0)
- 4)* GPS Server Status - DEFAULT(Monitored,Disconnected)
Apply, Return Buttons not shown in AMCAP
Setting

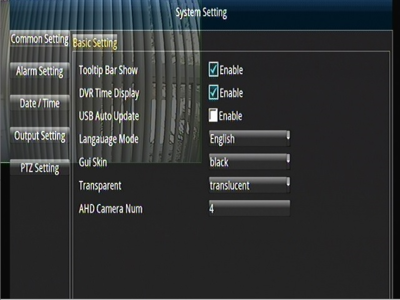

- Basic Settings
- 1)* Toolbartip Bar Show - Enable(Check)
- 2)* DVR Time Display - Enable(Check)
- 3)* USB Auto Update - DEFAULT(Not checked)
- 4)* Language Mode - English
- 5)* GUI Skin - Black
- 6)* Transparent - Translucent
- 7)* AHD Camera Num - 4
Apply, Return Buttons not shown in AMCAP

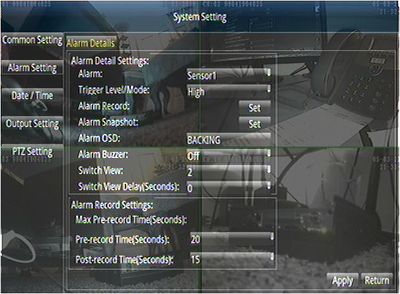

- Alarm Settings
- 1)* Alarm - Sensor1
- 2)* Trigger Level/Mode - High
- 3)* Alarm Record - Set
- 4)* Alarm Snapshot - Set
- 5)* Alarm OSD - DEFAULT(BACKING)
- 6)* Alarm Buzzer - DEFAULT(OFF)
- 7)* Switch View - DEFAULT(2) - this takes Channel 2 Full Screen when wire in engaged with 12VDC
- 8)* Switch View Delay(Seconds) - 0
- 9)* Pre-record Time(Seconds) - 20
- 10)* Post-record Time(Seconds) - 15

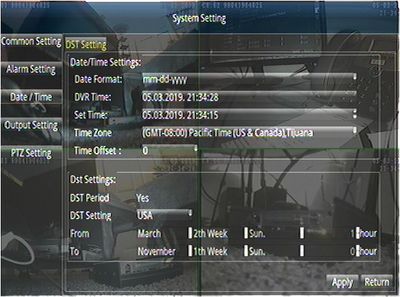

- DST Settings
- 1)* Date Format- mm-dd-yyyy
- 2)* DVR Time - DEFAULT
NOTE: set Time Zone (US Eastern, Central, Mountain or Pacific) and DST USA first before Actual Client Time;
- 3)* Set Time - DEFAULT(Input current date and time)
- 4)* Time Zone - (GMT-05:00) Eastern Time.
- 5)* Time Offset - 0
- 6)* DST Period - Yes
- 7)* DST Setting - USA
- 8)* From - DEFAULT(User Input)
- 9)* To - DEFAULT(User Input)

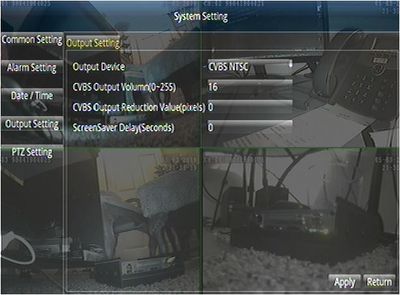

- Output Setting
- 1)* Output Device - CVBS NTSC
NOTE: this will set by the Config File installation to NTSC so you can use AMCAP and USB Video Adapter
DO NOT use PAL in the US with 7" US Monitors
- 2)* CVBS Output Volume(0-255) - 16 ?
- 3)* CVBS Output Reduction Value - 0
- 4)* ScreenSaver Delay(Seconds) - 0

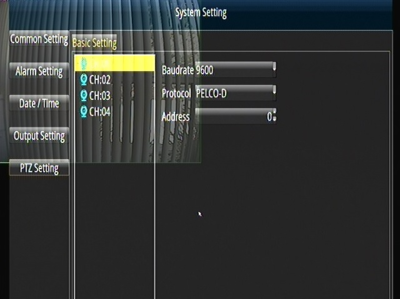

- PTZ Settings
Apply the following to all four channels.
- 1)* CH:01 - Baudrate 9600
- 2)* CH:02 - Protocol PELCO-D
- 3)* CH:03 - Address 0
- 4)* CH:04 - DEFAULT
Copy to, apply, Return Buttons not shown in AMCAP
File
- File

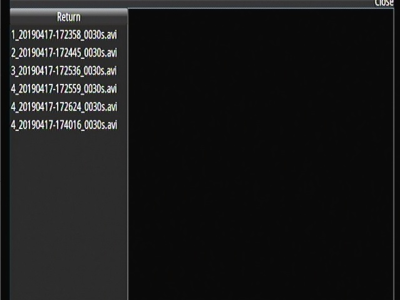

No Setup needed.
System

- System Info
- 1)* DVR App Version - V206-2019/4/12-10:11::12-4
- 2)* DVR MCU Version - 08/04/2018-0d
- 3)* Camera1 Version - NTSC
Apply, Return Buttons not shown in AMCAP

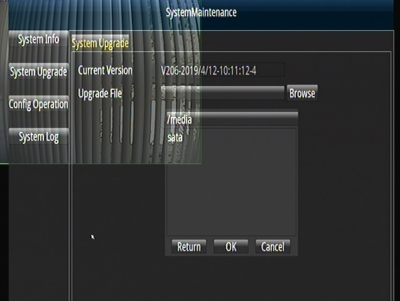

- System Upgrade
- 1)* Current Version - V206-2019/4/12-10:11::12-4
- Confirm Current Version is the latest version; if not, browse available resources for upgrade?
- 2)* Upgrade file - DEFAULT(Browse)
Upgrade, Return Buttons not shown in AMCAP
See the link Import Idrive Default Configuration for Idrive Configuration Downloading and Installation to D4M
<a href="https://admincenter.idriveglobal.com/wiki/index.php?title=New_D4M_(4/17/19)_Initial_Configuration_and_Setup#Import_Idrive_Default_Configuration>Loading Idrive Default Configuration</a>

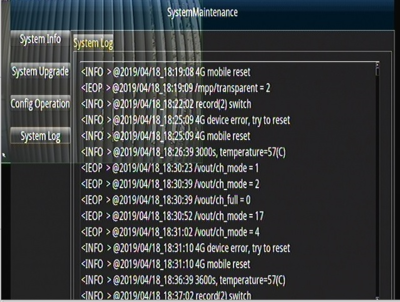

- System Log
- 1)* DISPLAYS LOG - DEFAULT(Refresh only if necessary)
Refresh, Return Buttons not shown in AMCAP
